Panoramic view of Heber Valley with snow-capped mountains and a small town at golden hour

Study Overview

The Utah Department of Transportation’s (UDOT) mission is to keep Utah moving while enhancing quality of life through transportation improvements in our state. UDOT is conducting an Environmental Impact Statement (EIS) to improve regional and local mobility on US-40 from SR-32 to US-189 and provide opportunities for non-motorized transportation while allowing Heber City to meet its vision for the historic town center.

Project Update

Revised Date: 11/16/2026

The Final EIS and Record of Decision (ROD) are expected to be published in Spring 2027. Additional updates will be provided as major technical evaluations are completed and when the updated project schedule is finalized.

Recent and upcoming activities include updates at the Wasatch County Council meeting, reviewing all comments received during the formal public comment period and developing responses, coordinating with property owners and evaluating the traffic operations and potential resource impacts of suggested design refinements to the alternatives.

Watch Draft EIS Summary Video

Heber Valley Corridor Draft Environmental Impact Statement (EIS) Virtual Meeting and Q&A: Jan. 27, 2026

Draft EIS Alternatives Map

The maps below show the alternatives evaluated in the Draft EIS and are best viewed on a desktop or laptop.

Current Phase​

Revised Date: 11/16/2026

Project Update

The Final EIS and Record of Decision (ROD) are expected to be published in Spring 2027. Additional updates will be provided as major technical evaluations are completed and when the updated project schedule is finalized.

Recent and upcoming activities include updates at the Wasatch County Council meeting, reviewing all comments received during the formal public comment period and developing responses, coordinating with property owners and evaluating the traffic operations and potential resource impacts of suggested design refinements to the alternatives.

Completed activities
Local Government Coordination

Public Outreach

  • Responded to stakeholder inquiries
  • Coordinated with property owners

Ongoing activities
Potential Alternative Shifts

As we have stated previously, potential alignment shifts in the North Fields and at 1300 South are being evaluated in response to public comments on the Draft EIS. We are using the same screening criteria and methodology to evaluate shift options that we used to develop and screen alternatives throughout the EIS process.

During the Draft EIS comment period, many community members expressed concerns about potential impacts to Agricultural Protection Areas (APAs), potential conservation easements, and agricultural operations. We are taking these resources into consideration as we evaluate shifting Alternative B farther east in the North Fields. The goal is to reduce impacts to these resources without negatively affecting the traffic performance by increasing out-of-direction travel.

For the 1300 South shift, the goal is to reduce impacts to neighborhoods, rural character, and the Heber Valley Special Services District sewer fields while minimizing negative impacts to traffic performance. This shift would be applied to both Alternative A and Alternative B.

The results of this screening evaluation will help inform which refinements will be incorporated into the alternatives and documented in the Final EIS. While we evaluate these refinements, Alternative B remains UDOT’s preferred alternative.

What to expect next
Final EIS Publication

We remain on schedule to publish the Final EIS and Record of Decision (ROD) in Spring 2027. We will provide additional updates as major technical evaluations are completed and when the updated project schedule is finalized.

To view the Draft EIS, please visit https://hebervalleyeis.udot.utah.gov/draft-eis/

Study Process & Timeline

The anticipated project timeline outlines the phases to accomplish development of the Heber Valley Corridor EIS. Ongoing engagement with the public will take place during the estimated time periods to keep the community informed during the EIS.

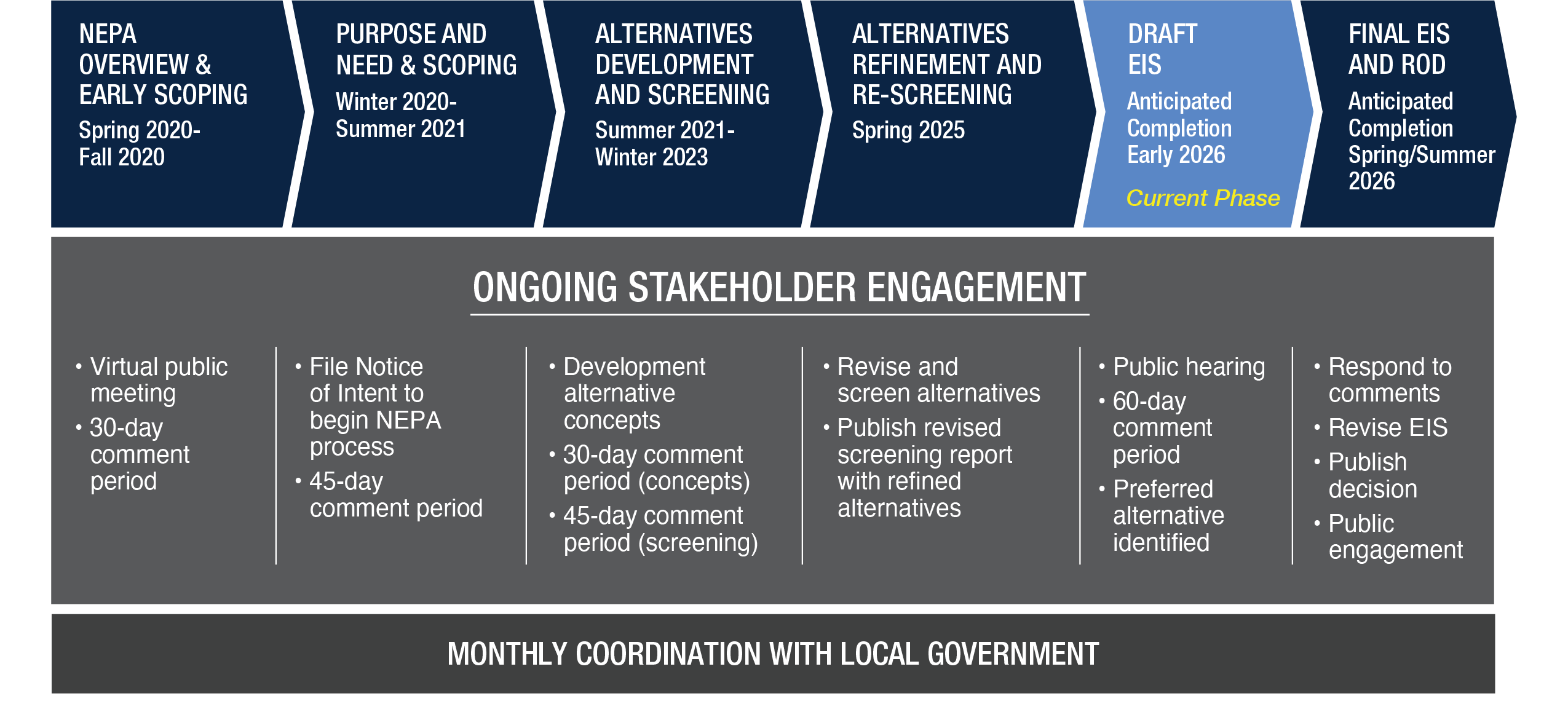

NEPA process timeline from Early Scoping (2020) to Final EIS and ROD (2026), current phase
